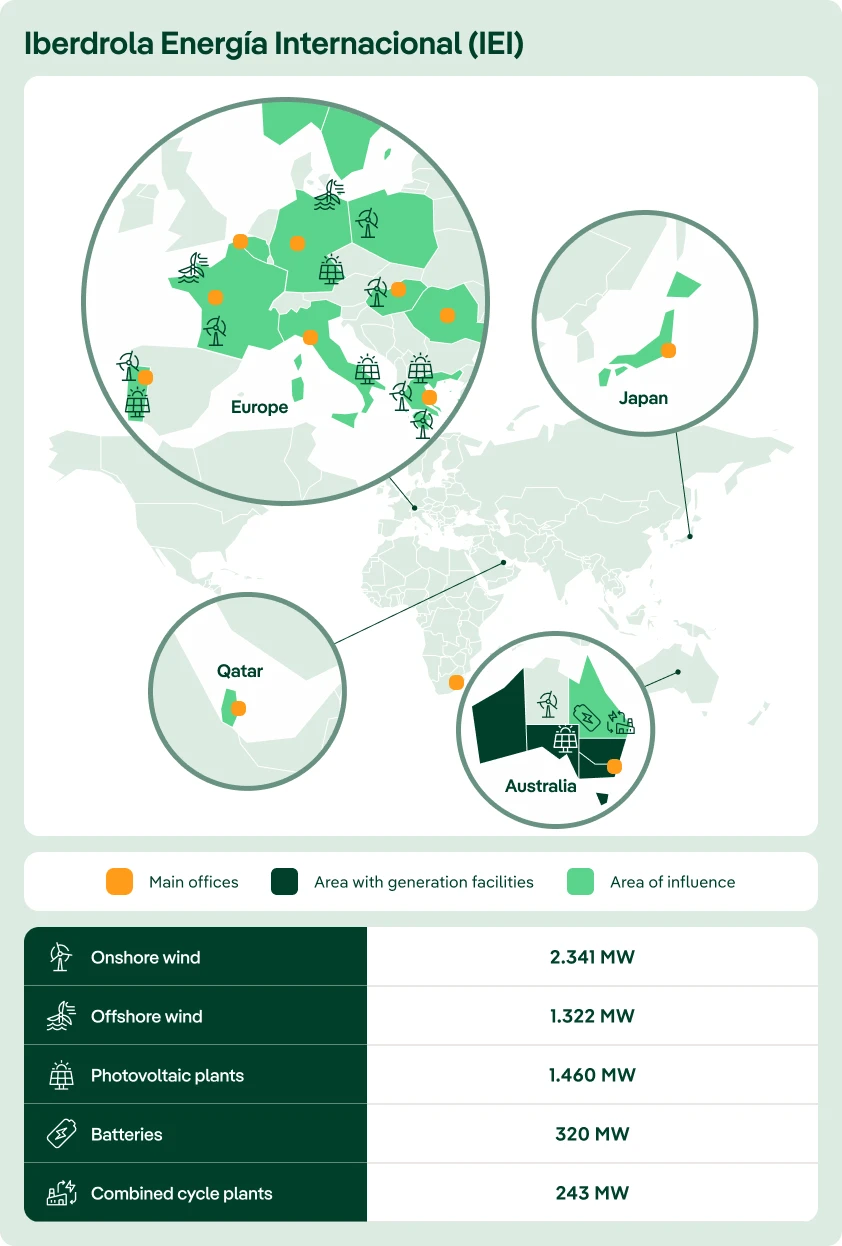

Operational Data

Get to know all the operational information of the company worldwide

This page shows the main operational figures of the different businesses of Iberdrola Internacional from around the globe.

Renewable installed capacity at year-end 2025 totalled 4,933 MW, up 20.3 % on the same period last year, broken down as follows:

IBERDROLA INTERNACIONAL
MW

Onshore Wind
2,062

Offshore Wind
1,322

Solar
1.229

Batteries
320

Total
4,933

The country-by-country breakdown of installed renewable capacity, as well as other information, is available on the company's facilities map.

In terms of photovoltaic solar technology:

  • In Germany, both the Boldekow (56  MW) and the Schadewohl (65 MW) projects are operating at full capacity.
  • In Italy, construction of the Fenix project (243 MW) in Sicily has now completed, and the facility is operating at more than 75% capacity. The Limes 15 (33  MW) and Limes  10 (18  MW) projects, both located in Lazio, are now installed, with Limes 15 operating at approximately 50% capacity.
  • In Australia, work continues on the Broadsound photovoltaic project (376  MW) and the batteries project (180 MW) located in the Queensland region. These projects are expected to begin commercial operations in April and July 2026 respectively. Installation and commissioning of the Smithfield battery (65 MW) in New South Wales has also now been completed.

Meanwhile, in onshore wind:

  • Construction on the Tâmega wind farm (274  MW) project in the north of Portugal, located in the districts of Vila Real and Braga, is progressing as planned. The project combines wind and hydroelectric energy, the latter being operational already.
  • In Greece, the wind turbines at the Gatza project (23 MW) have now been installed as planned.

Installed capacity breaks down as follows by country:

WIND, BATTERY AND PHOTOVOLTAIC
MW

Germany
947

Australia
1,905

Greece
444

Hungry
158

France
614

Portugal
277

Poland
213

Cyprus
20

Italy
356

The development of offshore wind projects also continues:

  • In Germany, construction at the Windanker project (315 MW), which is a partnership with Kansai (which owns 49% of the plant), is ongoing and operations are expected to come online in 2026.

Renewable production in 2025 reached 9,280 GWh, up 17.2 % compared to the same period last year, with the following breakdown by technology:

IBERDROLA INTERNACIONAL
GWH

Onshore Wind
4,427

Offshore Wind
4,134

Solar PV and batteries
719

Total
9,280

By technology, onshore wind production has decreased by 4.0% compared to the end of 2024, mainly due to the divestment in Romania (80 MW) in 2024 and lower wind resource

Meanwhile, offshore wind production (France and Germany) increased by 59.4% to total 4,134  GWh, mainly due to the commissioning of the Saint Brieuc wind farm (496  MW) in France and Baltic Eagle (476 MW) in Germany.

Furthermore, photovoltaic solar production totalled 720 GWh, up 1.2% from December 2024, mainly due to the new capacity in operation in Germany and Italy at the end of the year.

More information on the operating data of the aforementioned businesses of the Iberdrola Group by country can be found on the Group's Map of facilities and operating data page.
